In this article: Boca Raton’s recertification program comes with specific requirements, timelines, and submission steps that associations need to be aware of. In this article, we walk through how the process works, what the City expects, and how to prepare, so you can avoid unnecessary delays and extra costs along the way.
Building recertification in Boca Raton is, in theory, straightforward: Follow the guidelines, submit the required reports, and receive approval.
In practice, however, the process is rarely that simple.
Although the ordinance clearly outlines the requirements, it doesn’t fully reflect how the process often plays out. Through hands-on experience performing recertification inspections in Boca Raton, and by coordinating closely with the city throughout the process, we’ve seen where projects tend to slow down and how small oversights can lead to unnecessary delays.
Over time, clear patterns have emerged.
The good news is that most delays come down to a few common issues. With the right preparation, they can be avoided entirely.
In this article, we’ll walk you through how the Boca Raton recertification process really works, where projects most commonly get held up, and what you can do to keep the process moving as smoothly as possible.
How the Boca Raton building recertification process works
Boca Raton’s Building Recertification Inspection Program was established under Ordinance No. 5589 in 2021 and amended through Ordinance No. 5794, in effect since September 8, 2026. The updated ordinance clarifies which buildings require recertification, introduces additional inspection and reporting requirements, and revises deadlines for necessary repairs and extension requests.
For more background on the original program, see our overview of Ordinance 5589.
But in practice, the process involves more than what’s written in the Ordinance.

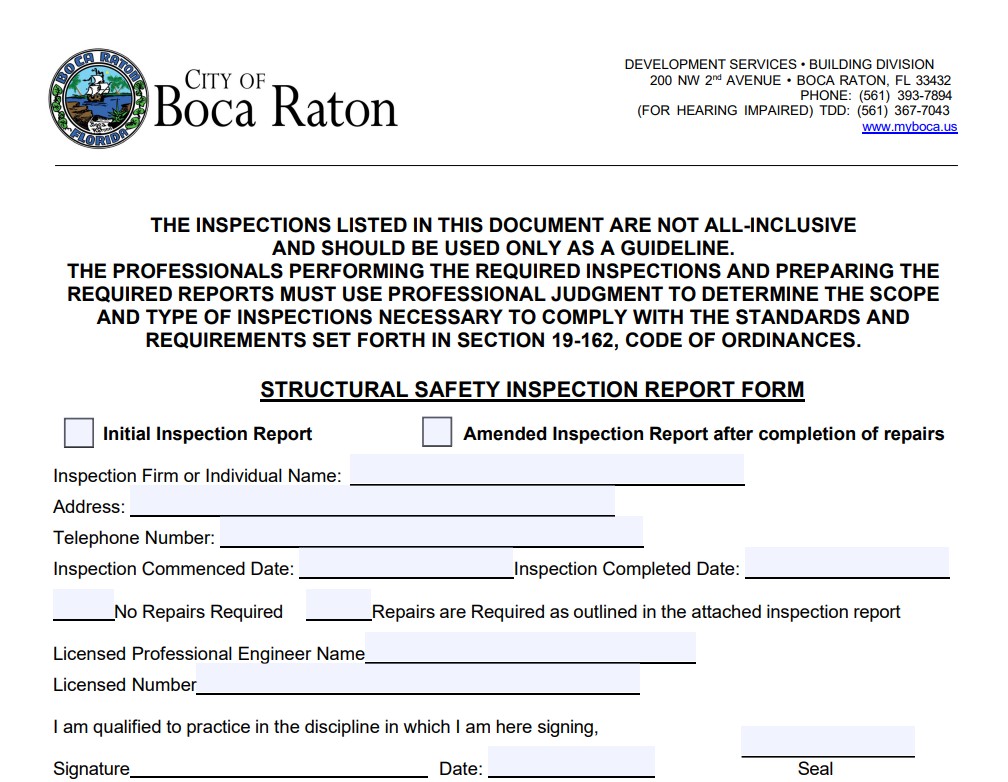

It starts with the inspection. A licensed structural and electrical engineer evaluates the building and prepares the required reports.
Once submitted through the city’s eHub portal the review process begins, but the reports do not go straight to the building official. They are first reviewed by a third-party engineer on behalf of the city. This step is easy to overlook, but it plays an important role in how the process unfolds.
After that review, the reports move on to the building official for final approval.
Because of these steps, recertification is not a one-step submission. It is a multi-stage review process, and each stage needs to be cleared before moving forward.
Even when everything is in order, the review process can take several weeks. If anything is unclear or incomplete, comments are issued and the timeline extends.
Understanding this structure makes a difference. What seems like a simple report submission is, in reality, a coordinated process with multiple checkpoints.
Common causes of delays in Boca Raton building recertification
In practice, delays usually don’t come from the process itself, but from a few recurring issues that show up during review. They are not always obvious, but if you know what to look for, you can prevent them and avoid unnecessary delays in your recertification.
Inconsistencies between inspection findings and the report
One common issue is inconsistent reporting. It happens more often than you might expect.
For example, during the review of an electrical inspection report, issues in electrical rooms are sometimes clearly visible in the inspection photos but are not fully described in the report itself. That creates a mismatch between what the reviewer sees and what is documented.
When that happens, the reviewer will ask for clarification. Instead of moving forward with approval, the report needs to be revised and resubmitted. That can slow the process down significantly.
Boca Raton’s updated ordinance also requires licensed engineers who discover dangerous conditions during an inspection to report them to the building owner or association, the fire marshal, and the building official within 24 hours. The engineer must also provide an opinion on whether any part of the building needs to be evacuated and how quickly.
Incomplete or unclear reports
Not all delays come from one specific issue. Sometimes the report as a whole leaves too much open to interpretation.
For example, descriptions may be too brief, certain observations are not fully explained, or the connection between findings and conclusions is not entirely clear. From the reviewer’s perspective, that raises questions.
When that happens, they will ask for clarification. That back-and-forth is what adds time and can delay approval, even when the underlying issue is minor.
Using the wrong report templates

Sometimes, reports are submitted using a format other than the official templates required by the City of Boca Raton. Since the city requires these templates for processing, reports submitted in a different format are typically rejected.
When that happens, the reports need to be redone using the correct templates and resubmitted before the review process can begin. This can delay the timeline significantly before the report even reaches the reviewer or building official.
Missing thermal imaging
Another issue that can delay recertification is missing thermal imaging, also known as infrared thermography, in the electrical inspection report.
Under Boca Raton’s updated recertification requirements, infrared thermography inspection reports are required for electrical systems operating at 400 amperes or greater.
If the required thermal imaging is missing, the building owner or association may need to arrange an additional site visit and submit an updated report before the review can continue.
This means additional coordination, potentially higher costs, and another delay in the recertification process. Confirming the electrical system’s capacity and planning for the necessary inspections from the start can help avoid these setbacks.
Submission and portal Issues
Not all delays are related to the inspection itself. In practice, issues can arise during the submission process. Reports may be submitted under the wrong application type, or the required documents are not uploaded in the expected way.
When that happens, the application may not move forward into review right away.
The right steps are easy to overlook, especially when working with the portal for the first time, but it can delay the start of the review without it being immediately obvious.
Each of the mentioned issues may seem minor on its own, but they often lead to additional review cycles. That is where time is lost. But with the right preparation and attention to detail, you will help your building move through the recertification process with fewer revisions, less back-and-forth, and a more predictable timeline.
At a glance: When structural inspections, electrical evaluations, and thermal imaging are handled together, it is much easier to deliver a complete report from the start and avoid unnecessary back-and-forth.
Practical tips to keep the process moving
Now that you understand where delays typically come from, the next step is knowing how to avoid them. In practice, a few small decisions early on can make a significant difference in how smoothly the process goes.
Work with a team that understands the local process
Recertification is not just about performing an inspection. It’s about understanding how the city reviews reports and what is expected in practice.
Working with engineers who are familiar with Boca Raton’s process and have experience with local Building Safety and Recertification Inspections helps avoid common issues before the report is even submitted.
Start the submission the right way

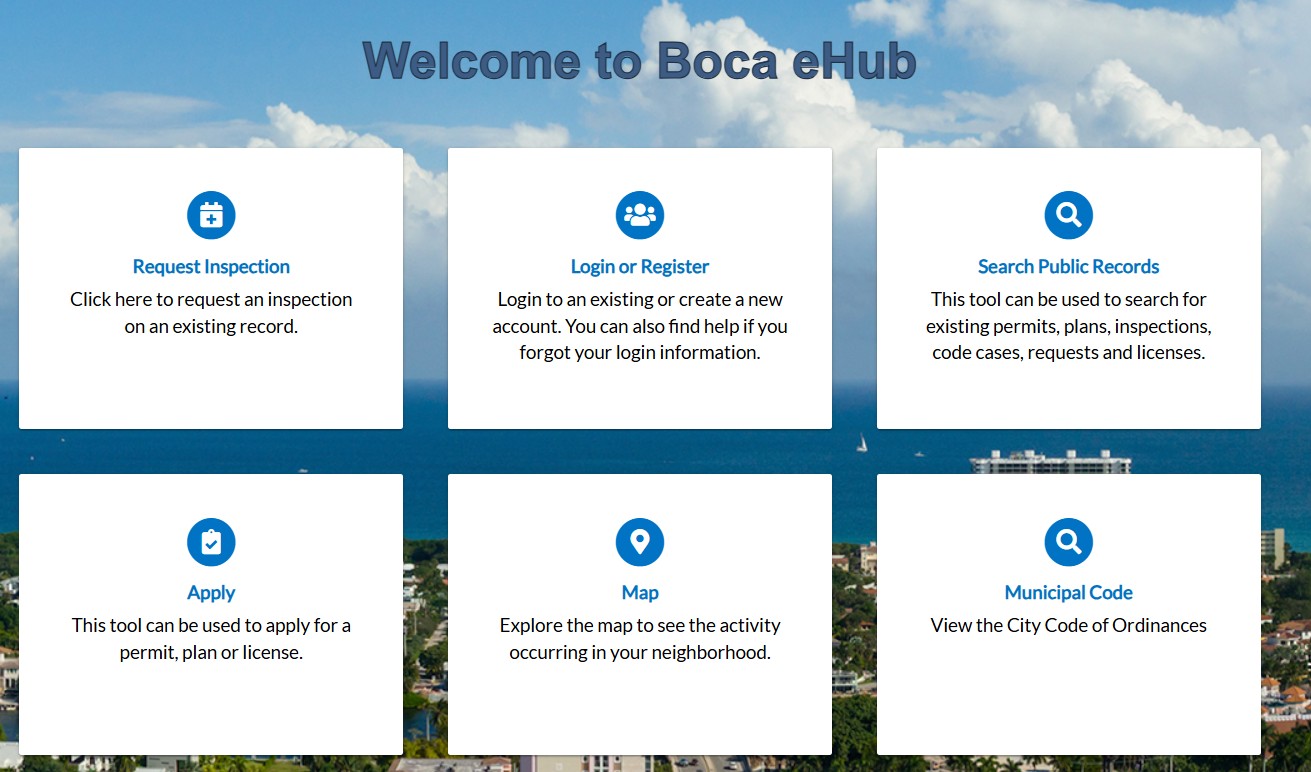

Source: City of Boca Raton eHub portal
The submission process in Boca Raton runs through the city’s eHub portal.
For building recertification, inspection reports should be submitted through the Application process (the button labeled ‘Apply’), not through the Request Inspection function.
Then, search for Building Recertification and move forward from there.
If something is unclear during submission, it is worth confirming the correct approach before proceeding by reaching out to the city’s Recertification Coordinator (find more details here). That alone can save time later.
Make sure the report tells the full story
Reviewers don’t just look at the report, they compare it to the supporting documentation.
Before submitting, take a moment to confirm:
- What is shown in the photos is clearly described.
- Observations and conclusions are aligned.
- Nothing is left open to interpretation.
Catching small inconsistencies early can prevent an extra review cycle later.
Don’t treat thermal imaging as an afterthought
Boca Raton’s updated recertification requirements make infrared thermography inspection reports mandatory for electrical systems operating at 400 amperes or greater.
Before scheduling the inspection, confirm your building’s electrical system capacity with your engineer and whether infrared thermography needs to be included.
Coordinating the electrical inspection and thermal imaging from the start can help prevent additional site visits, report revisions, and delays.
Coordinate all inspection scopes from the start
Recertification often involves multiple disciplines: structural, electrical, and in many cases thermal imaging.
When these are handled separately, gaps or inconsistencies are more likely to occur.
When they are coordinated from the start, it becomes much easier to submit a complete and consistent report. This reduces the risk of back-and-forth and helps your building move through the approval process without unnecessary delays.
Allow time for review, but avoid unnecessary cycles
Even when everything is done correctly, the review process takes time.
What makes the biggest difference is avoiding additional review cycles. Each request for clarification or revision adds time.
Submitting a complete report from the start is the most effective way to keep the process moving.
Plan ahead if your inspection identifies necessary repairs
If your recertification inspection identifies structural or electrical deficiencies, the clock starts ticking once the City accepts your report.
Under Boca Raton’s updated requirements, necessary repairs generally must begin within 365 days of the City’s acceptance of a compliant recertification report, unless the building official or engineer specifies a shorter timeframe. Repairs must be completed in accordance with applicable permits and building code requirements.
If repairs are needed, start discussing the scope, permitting process, and timeline with your engineer early. That gives your association more time to prepare and helps avoid unnecessary delays.
A predictable path to approval
Delays in Boca Raton building recertification are rarely caused by the process itself. They usually come down to a few recurring issues: small gaps or misalignment between what is expected and what is submitted.
Once you understand that, the process becomes much easier to navigate.
When the process is understood and handled correctly, recertification becomes far more predictable, and approval can be achieved without unnecessary delays or surprises.
How our engineers help with Boca Raton building recertification
Building recertification in Boca Raton involves more than completing the required inspections. Understanding the city’s procedures and expectations can make the process considerably smoother.
With experience across numerous Boca Raton recertification projects, Building Mavens brings structural, electrical, and infrared thermography expertise together under one roof. Our engineers help you navigate the process, from initial inspections through any required follow-up.
If your building is approaching its recertification deadline, explore our Building Safety & Recertification Inspection Services or contact our team to discuss your next steps.

About the Author

Scott’s background is extensive, covering both public and private projects. He’s highly skilled in structural engineering design, construction oversight, and forensic analysis. This includes investigating structural failures, construction defects, and code compliance – all critical to maintaining safety and adhering to building codes. Beyond his investigative work, Scott is also an accomplished design engineer, contributing to various architectural elements from building envelope systems to designs for a wide range of structures. From the initial concept to the final inspection, Scott is dedicated to providing innovative and compliant engineering solutions.
